Accumulate
The service reads completed work and builds a per-unit history. Nothing is published and nobody is notified. If your warehouse already holds cycle history, this phase is largely already done and the runway shortens accordingly.
BCMMINING TECHNOLOGY
Home / Solutions / Operations Advisor
Production deployed
Product maturity · Data and deployment requirements
Threshold alerting needs somebody to know the number in advance. Most of what quietly costs an operation money has no number: a haul route that got slower, a drill that dropped off its own average, a face that stopped behaving like itself. This compares every unit of work against its own history and writes up the departures, with the effect size, the sample it is standing on, and how confident it is.
In practice

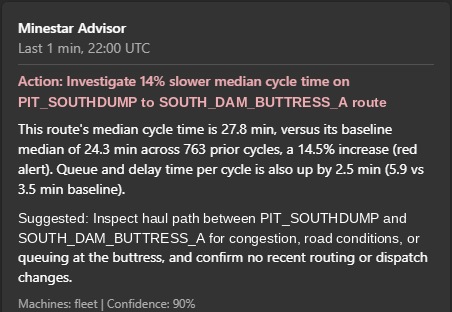

Two findings on the same haul route, at different points in the shift. Nobody configured a limit for either. The route was measured against its own median across several hundred prior cycles, and the wording, colour and confidence all move with the size of the departure.
What to notice: a second signal has to agree before either card appears, queue and delay time on the same route, which is what separates a genuinely slower haul from ordinary variation. The sample count is on the face of the card so a supervisor can weigh it in seconds. And the suggestion names what would make it a false alarm, a recent routing or dispatch change. An advisory that tells you how it could be wrong is one people will act on.
And that they are graded: five percent is amber, headed Attention, at 85 percent confidence. Fourteen and a half percent is red, headed Action, at 90 percent. Small drift gets noted rather than escalated, so a channel stays triageable by scrolling instead of reading.
Screenshots from production systems. Site identifiers, serial numbers and personnel details have been altered. Public demos use synthetic data.
The baseline
The advisor cannot report anything until it knows what your operation's normal is, and a baseline is not something that can be shipped in a box. It has to be accumulated from your own completed work. Several hundred cycles on a route before a comparison is worth making, which a busy haul reaches in days and a road to a rarely used dump takes considerably longer. Through that period the service is running and building history, and it says nothing.
This is worth being direct about, because it is the honest test of any advisory system sold into mining. Anything that starts making confident claims about your operation in its first week is not comparing your operation to itself. It is comparing you to a model built somewhere else, on somebody else's pit, somebody else's fleet, somebody else's haul profile. The waiting is what makes the output about you.
The service reads completed work and builds a per-unit history. Nothing is published and nobody is notified. If your warehouse already holds cycle history, this phase is largely already done and the runway shortens accordingly.
Findings are generated but held back for review rather than posted to a channel. You see what it would have said, and the sensitivity gets set against what your supervisors actually found when they went and looked.
Advisories start arriving in the channel, graded. The baseline keeps moving from here, so the reference is always recent history rather than a number frozen at commissioning.
Because it is recomputed rather than fixed, the comparison stays valid as the pit deepens, routes change and the fleet turns over. A threshold set at commissioning is wrong within a quarter and nobody notices.
Mechanism
Scope
The cards above happen to read a Cat Minestar dataset, but the method needs only a history of completed work with a start, an end, a duration, and somewhere the time went. Availability and semantics vary by fleet system and approved export. Once those records are in your own warehouse, the advisor reads the warehouse rather than any vendor's schema, with interface changes assessed and revalidated when a fleet system changes.
Drill patterns against their own metres per hour. Crusher throughput by feed source. Loading tool performance on a given face. Plant recovery by ore type. Pump runtimes, tyre life by route, fuel burn by machine and grade. Wherever an operation has a normal it never wrote down, there is something here to compare against.
The advisor is a consumer of the governed warehouse rather than a separate stack. If the shift calendar, the rehandle logic and the coordinate transforms are already settled there, the advisory inherits definitions everyone already agrees on.
Production deployed
The learned machine-learning model runs in production alongside the statistical baseline advisor. It adds pattern analysis across multiple variables while the baseline provides the historical comparisons behind an advisory.
Teams can review the operating context, sample counts and comparisons when investigating a finding. The model and baseline work together to support traceable operational decisions.
Next step
If you can answer that, you did not need this. The interesting version of the question is how you would know, and that is usually the whole conversation. Tell us what history your systems keep and the runway becomes obvious quickly.
